Once your Pre-Qualification Application has been Selected, you may submit applications for individual projects (e.g. specific mini-grid sites) on a rolling basis.
The information module of the project contains the site information that was provided when creating the project. Learn more about completing your site information.
UEF Requirement:
Ensure you name your project using the following naming convention: "[Community Name]". If you are submitting an expansion site, name your project using the following naming convention: “[Community Name] - Expansion”
Project Application
In the Project Application, you’ll complete the form with information on your site development including whether it is an expansion site or new mini-grid.
In the Document checklist, you must upload the following files:
Local Support - MOU or letter from proposed site’s community council, executive, chief, or other community-level person/entity with competent authority to grant local project approval/support
Financial resources - Bank statement(s) showing cash balance as dictated in section 4.6 “Available cash” of the UEF Operating Manual, plus letters of commitment from related parties if bank accounts are not held by the Applicant
Legal and licensing compliance - EIA reports and certificates for all proposed sites, evidence of application being undertaken, or appropriate exemption from regulatory body, as required in country of operation
Other concessional funding - Official notarized letter from applicant stating that the proposed project has not received other site-specific connection-based concessional funding, including but not limited to tender awards, grants, subsidies, and incentives
A signed warrant (Appendix A) specifying that the Applicant has read, understand, and will comply with the technical standards this document and the design and component requirements in Appendix A.
Load

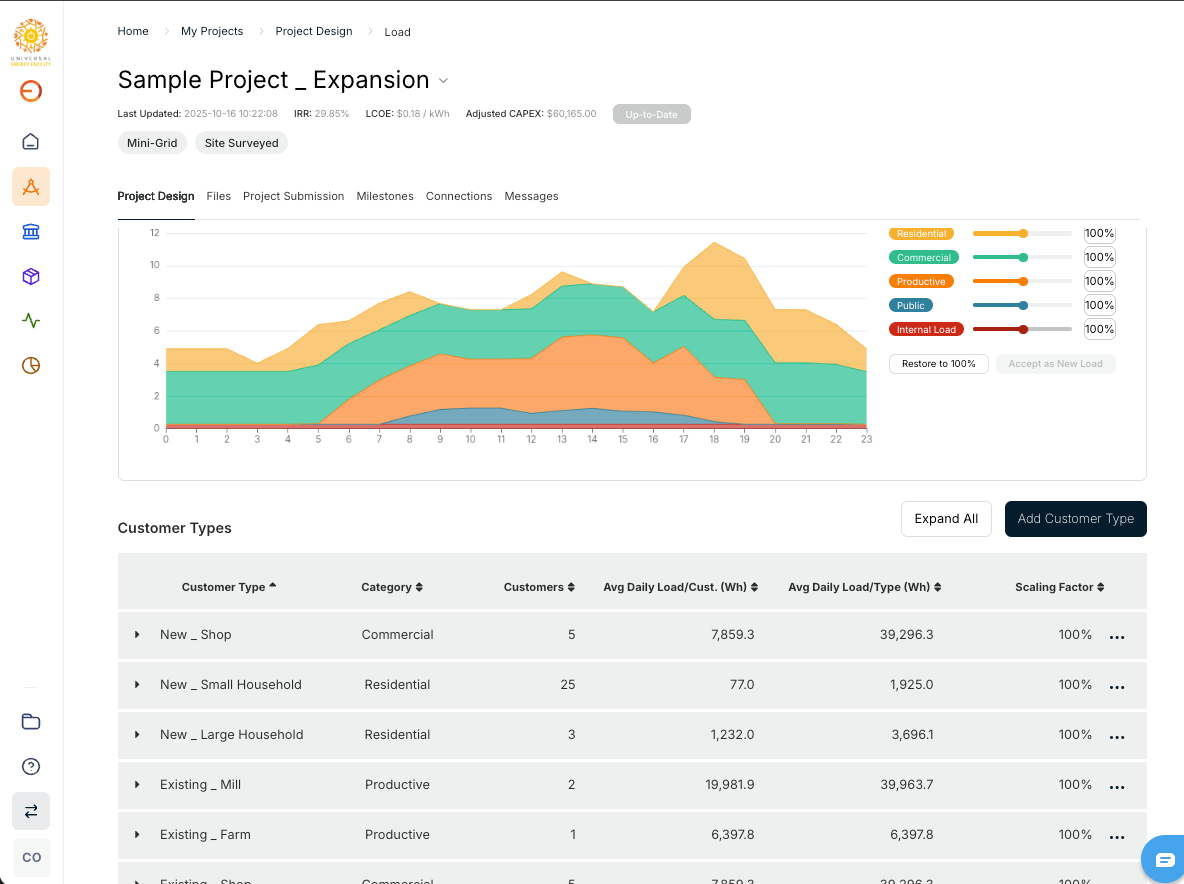

In the load module, you will provide information on the number and type of customers as well as the projected load profile. Learn more about creating a load assessment.
Submitting a mini-grid expansion project? Please follow the steps below:
Tracking existing customers - create a customer type for each existing customer group and name the customer type “Existing _ [Customer type name]”
Tracking new customers - create a customer type for each new customer group you plan to serve through the grid densification upgrades and name the customer type “New _ [Customer type name]”
Generation Design

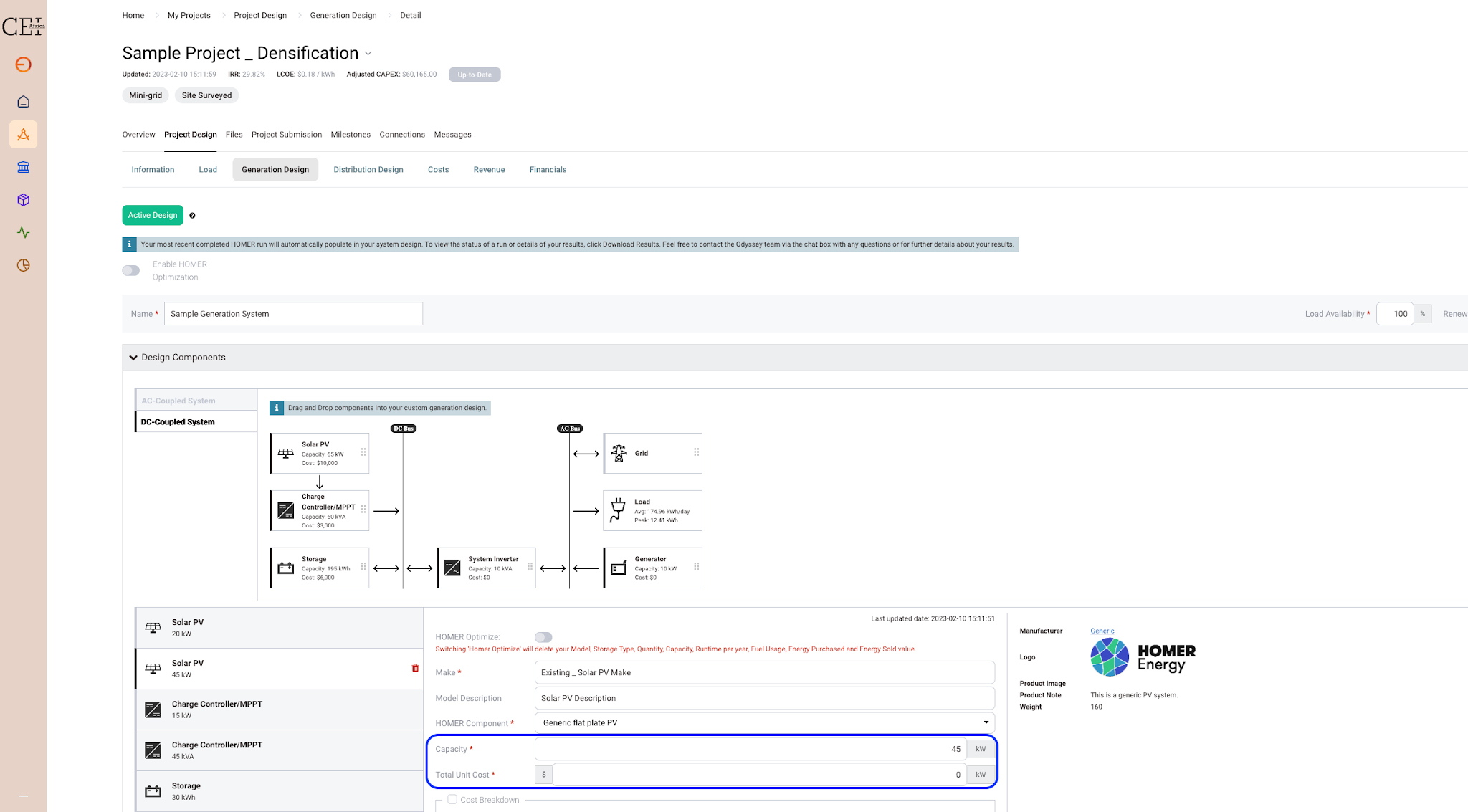

Once your load profile in Odyssey is complete, you can design a generation system.
Odyssey is integrated with HOMER Energy to enable rapid system design based on your load assessment. Learn more about designing your generation system
UEF Requirement: The proposed generation design must have a load availability of at least 97% and renewable energy production of 60%, verified via the UEF Platform’s embedded HOMER module. If HOMER cannot be used, please provide other technical justification in the Information > Project Files section of your Site-Specific Project Application.
Submitting a mini-grid expansion project?
Complete information on each component in your existing mini-grid and enter $0 for the Total Unit Cost for all components existing at the site
If you are expanding the generation system:
Deselect the toggle next to Enable HOMER Optimization to disable HOMER at the top of the page.
Drag and drop a second component into your system for all new components being added to the system and include the Total Unit Cost of the components related to your grid expansion
Distribution Design
Input capital expenditures related to the distribution network and customer connections. Learn more about inputting distribution design costs.
UEF Requirements:
Distribution assets must be grid compatible and approved by the host country regulatory body.
Grantees must use customer metering solutions that can be integrated with the UEF Platform. This enables the UEF to remotely verify connections in an efficient and affordable manner.
Submitting a mini-grid expansion project?
Only include the distribution network and customer connection costs required for the expansion of the distribution system at the mini-grid expansion site.
General Costs
Input general costs related to site development and operating expenses. Learn more about tracking general costs.
Submitting a mini-grid expansion project?
Only include the costs and balance of materials required for the expansion of the distribution system at the mini-grid expansion site.
Revenue
The Revenues module calculates your revenues based on your defined tariff structure and forecasted load profile. Learn more about entering revenue structures.
Select the currency that the revenue is collected as at the top of the page.
Financial
In the Financials section, you will enter project-level sensitivities and account for ramping/growth rates for your load assessment. The financial page uses all the information you entered into Odyssey to calculate key financial metrics. Learn more about calculating project financials.
