Regional Site Lots | Site |
1. Oromia | 1.1 Chefe Kora |
1.2 Dalle | |
1.3 Huluku | |
1.4 Moko | |
2. Amhara | 2.1 Andega |
2.2 Aregawi | |
2.3 Telifa | |
3. SNNP/ Sidama | 3.1 Lelicho |
3.2 Murche |
Milestone 1 – Inception
Feasibility studies finalized
Request to Arene for concession submitted
Identification/agreements with suppliers finalized
Key positions of the team completed
Amount in co-investment confirmed
Milestone 2 – Construction
Equipment/components in the site
Concession from Arene as being granted
Percentage of the civil/electrical work concluded
Amount (£) in co-investment confirmed
Milestones 3 – Pre-Commissioning
Number of connections concluded
Amount in co-investment confirmed
You are allowed to include any additional load you want to power but do not edit the existing load profiles. Learn more about creating a load assessment.
Odyssey is integrated with HOMER Energy to enable rapid system design based on your load assessment.
HOMER can be used to either optimize the sizing of each component or to validate that your pre-specified system capacities will meet the load specified. Learn more about designing your generation system.DREAM Requirement:
- System Topology - Either AC or DC coupled systems are acceptable.
- The proposed generation design must have a renewable energy production of greater than 90%, verified via the Platform’s embedded HOMER module. If HOMER cannot be used, please provide other technical justification in the Information > Project Files section of your Full Proposal.
- Entering 90 (%) in the Min Renewable Fraction section would discard any HOMER optimized systems that have the generator running to meet greater than 10% of the load annually.
- Make sure the annual generation estimate from non-sustainable sources isn't greater than 10% any 12 month period
- Use Lithium Iron Phosphate (LFP) batteries when modelling your system
- The duration of power supplied from the designed system must be at least 20 hours/ day
- You do not need to pull the grid component as the sites are not connected to the grid
- You must include 15kV or 33kV, Medium voltage lines in your design
- Distribution voltage should be 230 single-phase (Households) and 400 volt 3 phase (PUE)
- You are required to use a metering platform that can interface with the national mini-grid tracking platform of the Government of Ethiopia. A metering platform used in the project must collect meter consumption and other related usage data from each connection at least on an hourly basis, with the capability to integrate with external applications via a publicly available Rest API.
- Tariffs for the main customer types should not exceed the amount stated below
- All tariff prices should be in USD
- Forex (indicative rate) - 1 Ethiopian Birr = 0.0197 USD
- Make sure the expected life span of your project is 20 years.
- The baseline line year should be Year 2
Regional Site Lots | Site |
1. Oromia | 1.1 Chefe Kora |
1.2 Dalle | |
1.3 Huluku | |
1.4 Moko | |
2. Amhara | 2.1 Andega |
2.2 Aregawi | |
2.3 Telifa | |
3. SNNP/ Sidama | 3.1 Lelicho |
3.2 Murche |

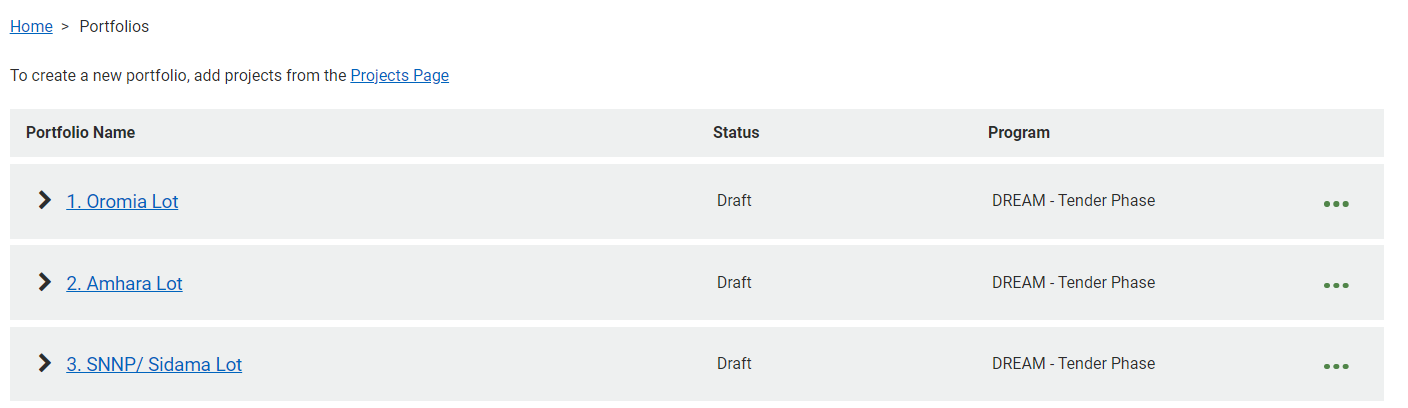

- Navigate to the Finance > Portfolios section of your account
- Navigate into the lots you are interested in to view the project sites in the lot
